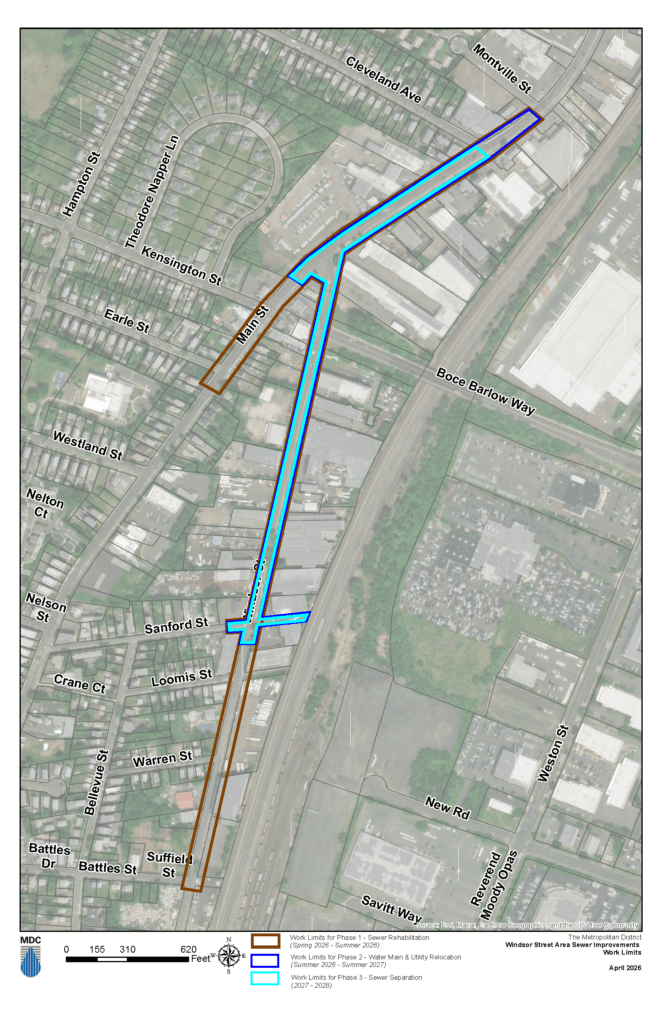

PHASE 1 – SEWER REHABILITATION (Cleaning, Inspection, and Lining) Rehabilitate existing sewer with lining “no-dig” technology Existing sewer will need bypass pumping and excavation work Project will extend life of sewer 50+ years with minimal disruption to community
Work Schedule Cleaning & Inspection of Existing Sewers – Complete Setup bypass pumping (April) Lining sewer & point repairs (May) Lining laterals (June – August)
PHASE 2 – WATER MAIN REPLACEMENT Water mains have reached the end of their useful life Traditional “open cut” replacement of main and services Installing exterior meter “pits”
Tentative Schedule Water main installation (August 2026 – November 2026) Water service installation (October – May 2027) Sidewalk and Road Restoration (June – July 2027)PHASE 3 – STORM DRAIN INSTALLATION (August 2027 – December 2028) Installation of a separate pipe to handle drainage and allow for separation of sewer and stormwater
