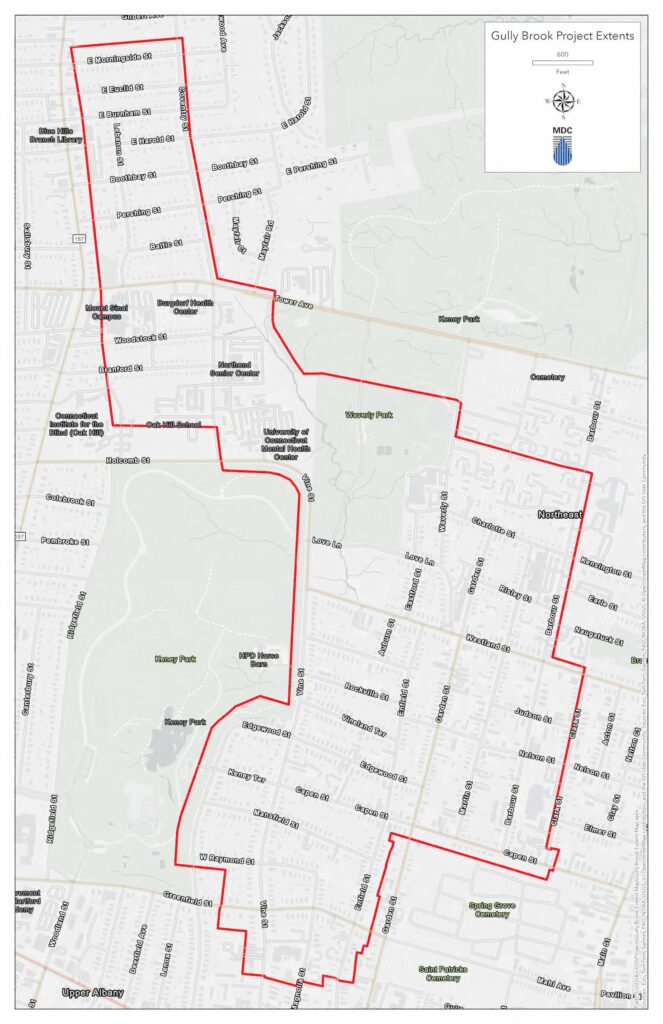

Project Area map of Gully Brook ProjectProject: The work consists of CCTV & Cured in place piping of 46,750 (8.8 miles) of sewer main prior rehabilitation, reconnection of 1,900 active service laterals, 136,750 linear feet of Service Lateral Lining from the main to the building or cleanout, 700 LF Sewer Main Replacement, 121 point repairs, 100 cleanout installations among additional improvements.
Number of Properties: 1040Contractors: BLD ServicesSchedule: Q4 2024 – Q42026Cost: $20.3MWork Completed:59% of mainline sewer lining completed13% of lateral lining completedProject Outreach Construction Notices:
